Dec 12, 2022

The critical path to Thanksgiving turkey success

Moovila’s step-by-step guide to delivering your Thanksgiving turkey on time and on temperature

‍

By

,

,

It’s you versus 16 pounds of poultry. What could go wrong? We've all found ourselves googling, “Fastest ways to thaw a turkey” at the eleventh hour leading up to deliver our Thanksgiving feast. After a busy week, just throwing the bird in the bathtub and hoping to not poison 20 of your closest family and friends seems like the best execution plan.

But not this year.

This is the year you stop winging it.

Moovila takes the guesswork out of timing, risk, and sequencing (yes, even for Thanksgiving).

Using our Critical Path Engine, we mapped out the exact sequence for getting that bird thawed, prepped, cooked, and on the table on time and without the usual chaos. Yes, we’re nerds. But you’ll know exactly what to do and when to do it, with zero guesswork and no day-of meltdown. Consider it your risk-free, on-time turkey plan so you can actually enjoy the holiday.

ree

Not all turkeys are created equal. So, here are the steps you need to take to determine your turkey’s critical path.

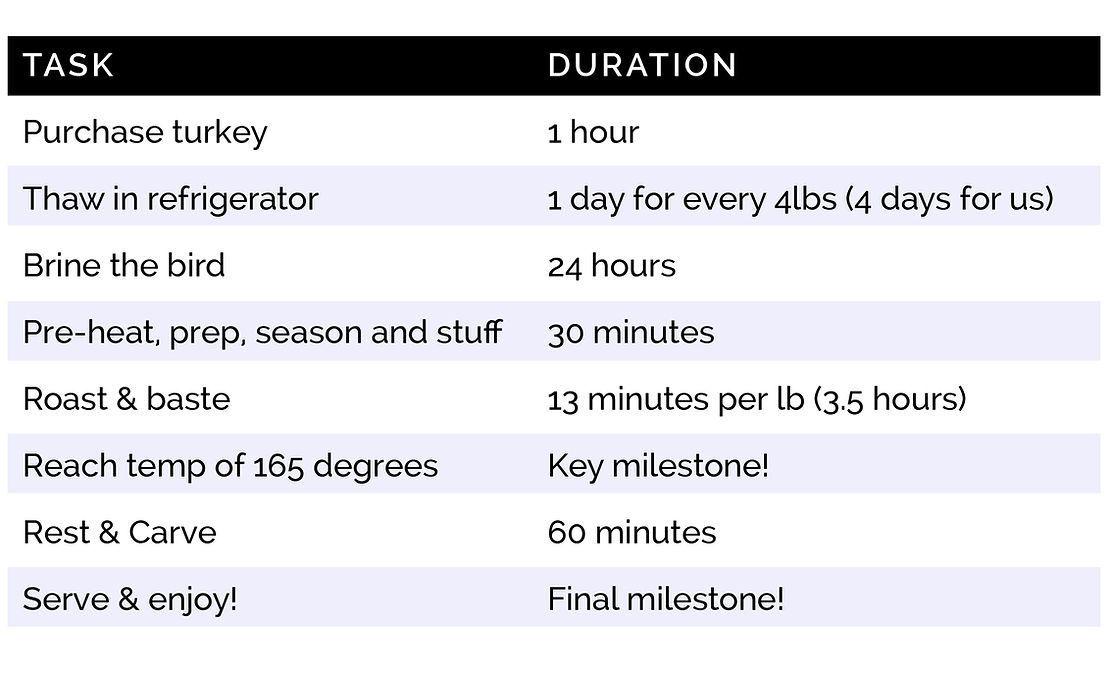

Lay out the tasks and determine durations.

In this example, we are going to use a 16-pound turkey.

ree

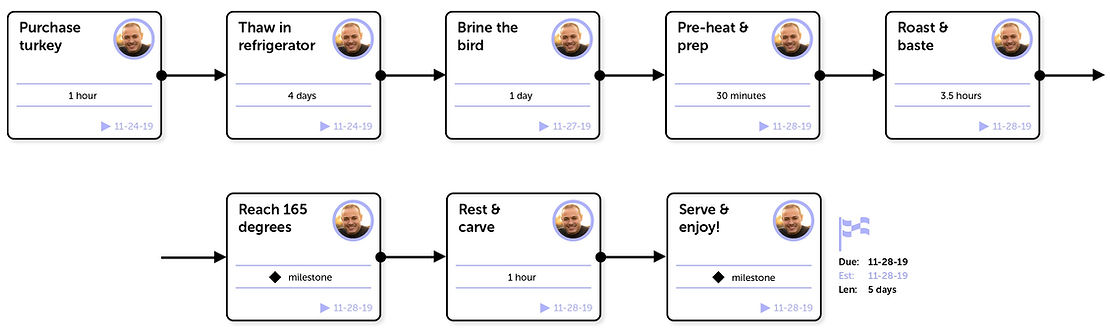

Next, create your turkey’s critical path.

First, map out the dependencies. In this case, we clearly need to complete the tasks in the order they are listed. Then, choose the time you wish to eat on Thanksgiving Day and work the timeline backwards to determine your latest possible start date and time for each task.

‍

ree

Now that you have a plan in place, gather your team, assign accountability for tasks, divide and conquer! You’ve got this Thanksgiving under wraps. And don't worry, if you do slip behind schedule, Moovila will automatically alert you of any hiccups and help you adjust your timeline to get back on track.

Learn more about our Critical Path Engine or book a demo today!

Project Management
